Force Majeure and Delay: A Causation Problem Disguised as Law

Force Majeure and Delay: Why Causation Matters More Than Classification

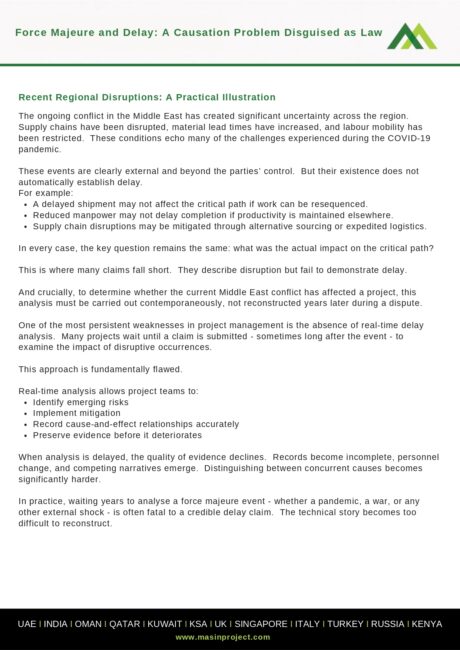

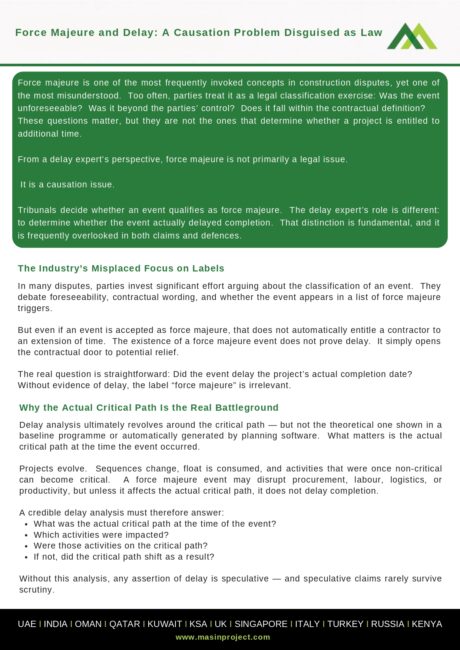

This article explores how force majeure claims in construction disputes are often misunderstood as purely legal issues, when in reality they are fundamentally questions of causation. It argues that simply proving the existence of a force majeure event — such as war, COVID-19 disruptions, or supply chain failures — is not enough to justify an extension of time. The critical issue is whether the event actually impacted the project’s critical path and delayed completion. Through practical examples and arbitration insights, the article highlights the importance of contemporaneous delay analysis, robust project records, and evidence-based assessments. It concludes that successful delay claims depend not on labels, but on proving a clear causal link between the disruptive event and project delay.

Frequently Asked Questions

Get answers to frequently asked questions about everything we do.

What is force majeure in construction disputes?

Force majeure refers to extraordinary events beyond the parties’ control — such as wars, pandemics, or natural disasters — that may affect project performance and potentially entitle a contractor to relief under the contract.
